Concrete Batching Plant Weighing Accuracy: The 2026 Guide for Australian Producers
Share

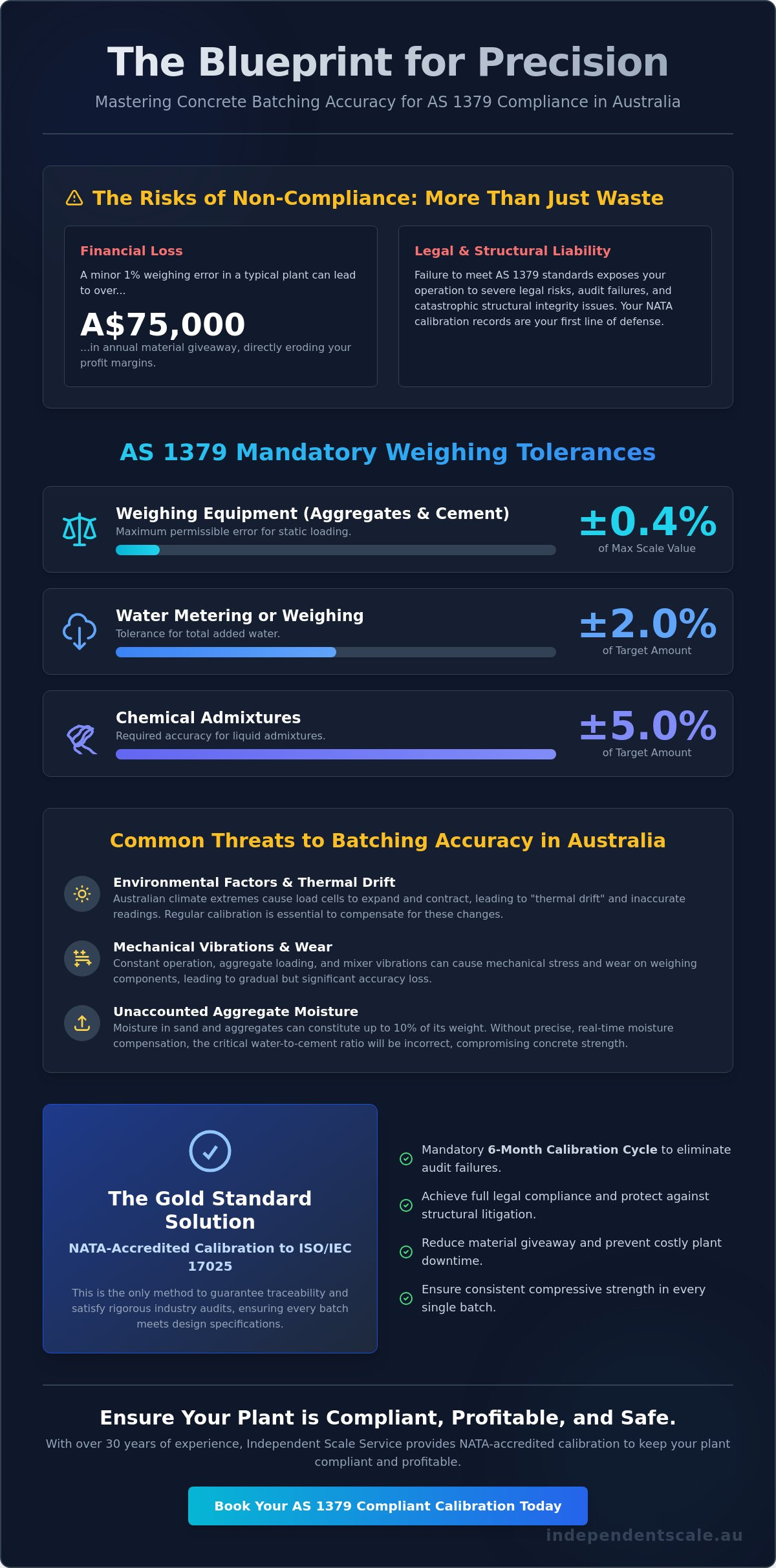

A single out-of-tolerance load cell doesn't just waste material; it compromises structural integrity and exposes your operation to severe legal risks under AS 1379. Maintaining precise concrete batching plant weighing accuracy Australia wide is a mandatory technical requirement, not a suggestion. You're likely already aware that even a minor drift in your scales leads to expensive product giveaway or, worse, batches that fail to meet specified strength targets. These errors directly impact your bottom line and your reputation with Tier 1 contractors.
At Independent Scale Service, we've spent over 30 years ensuring Australian producers meet these rigorous standards through NATA-accredited calibration to ISO/IEC 17025. This guide details exactly how to achieve the ±0.4% static loading accuracy required for weighing equipment and the specific tolerances for water and admixtures. You'll learn how to implement the mandatory six-month calibration cycle to eliminate the fear of audit failures and ensure every batch is consistent. We'll examine the technical requirements for gravimetric testing and digital traceability to keep your plant compliant and profitable throughout 2026.
Key Takeaways
- Learn the specific tolerance requirements under AS 1379 to ensure full legal compliance and structural safety for every batch produced.
- Master the technical steps to maintain concrete batching plant weighing accuracy Australia wide, ensuring your plant meets the ±0.4% static loading threshold.
- Identify how Australian climate conditions and mechanical vibrations cause load cell thermal drift and learn how to mitigate these accuracy killers.
- Understand why NATA-accredited calibration to ISO/IEC 17025 is the only way to guarantee traceability and satisfy rigorous industry audits.
- Discover how proactive maintenance and high-precision load cell upgrades reduce material giveaway and prevent costly plant downtime.
Why Weighing Accuracy is the Foundation of Concrete Quality in Australia
Weighing accuracy is the heartbeat of any production facility. If you don't measure your constituents correctly, you aren't making concrete; you're making a liability. To understand what is a concrete batching plant in a professional context, you must view it as a high-precision laboratory. Every gram of cement and every litre of admixture counts toward the final performance of the product. Precision in the measurement of aggregates, cementitious materials, and liquids is the only way to ensure the mix delivered to the site matches the engineer's design.
Achieving consistent concrete batching plant weighing accuracy Australia wide requires a deep understanding of gravimetric precision. A 1% error in cement weighing doesn't just change the mix; in a plant producing 100,000 cubic metres annually, it can result in over A$75,000 in material giveaway. This waste erodes profit margins while increasing the risk of structural non-compliance. In 2026, with rising material costs and tighter environmental regulations, this level of waste is no longer sustainable for competitive producers.
The Role of AS 1379 in Australian Construction
AS 1379-2007 (R2017) is the definitive standard for the specification and supply of concrete. It mandates that weighing equipment must be accurate to ±0.4% of the maximum scale value when statically loaded. Water must be metered or weighed to within ±2.0%, and admixtures must be within ±5.0%. These aren't suggestions; they're the benchmarks for AS 1379 compliant calibration services. The National Measurement Institute (NMI) and NATA-accredited bodies enforce these tolerances to ensure "trade-to-weight" integrity across the supply chain. If your plant hasn't been checked in the last six months, you're likely operating outside these mandatory legal requirements.
Structural Integrity and Liability
Inconsistent batching leads to erratic compressive strength. If the water-to-cement ratio drifts by even 0.05, the resulting slump and strength changes can lead to honeycombing or premature cracking in finished structures. The chain of responsibility starts at the batcher. Site engineers rely on your batch dockets to be accurate representations of what's in the truck. Accuracy is the only defense against structural litigation. If a slab fails a core test, your NATA-accredited calibration records are the first documents a lawyer or auditor will request. Maintaining concrete batching plant weighing accuracy Australia wide protects your business from the catastrophic costs of structural failure and legal disputes.
Understanding the Mix of Concrete Ratio and Gravimetric Precision
The "mix of concrete ratio" is more than a recipe; it's the technical blueprint for every pour. It dictates the specific proportions of cement, water, fine aggregates, and coarse aggregates required to reach a target compressive strength. Achieving this ratio consistently depends entirely on your hardware's ability to translate digital commands into physical mass. If your sensors drift, the blueprint fails, and the structural integrity of the project is compromised before the truck even leaves the yard.
Precise measurement of these components is vital because even a minor shift in the water-to-cement ratio significantly alters the workability and durability of the finished product. To maintain high concrete batching plant weighing accuracy Australia producers must account for aggregate moisture content. Since aggregates are often stored outdoors, their water content fluctuates. Modern batching systems must weigh these materials and adjust the added water in real-time. This level of control is impossible without high-quality industrial load cells that provide stable, repeatable data under heavy industrial loads.
The Science of the Correct Mix Ratio
The water-to-cement ratio is perhaps the most sensitive variable in concrete production. A slight over-addition of water increases porosity and reduces the final strength of the slab. Conversely, too little water makes the concrete unworkable. Because moisture in sand can represent up to 10% of its weight, static weighing isn't enough. You need dynamic systems that integrate moisture probe data with load cell readings to hit the exact mix ratio every time. This ensures the concrete batching plant weighing accuracy Australia regulators expect is maintained across every load.
Gravimetric vs. Volumetric Batching
Australian standards for structural concrete heavily favour gravimetric (weight-based) batching over volumetric methods. Gravimetric measurement is inherently more accurate because it's unaffected by material density changes or aeration. Volumetric batching, which relies on the space a material occupies, can be misled by "bulking" in damp sand. In a gravimetric system, the mass remains constant regardless of volume. To ensure this data reaches the control room without interference, conditioners and transmitters are used to clean and amplify the electrical signals from the scale.
Admixture precision is another critical factor. While AS 1379 allows a ±5.0% tolerance for admixtures, exceeding this can cause unpredictable set times or air entrainment issues. A small error in a high-range water reducer can turn a standard mix into a "soupy" mess that fails slump tests. If you suspect your chemical dispensers are drifting, it's essential to perform a liquid flowmeter calibration using the weighing method to verify performance and protect your batch quality.
Environmental and Mechanical Factors Affecting Batching Accuracy in Australian Plants
Even a perfectly calibrated plant can suffer from accuracy degradation due to external variables. In the Australian industrial environment, environmental and mechanical interferences are the primary causes of non-compliance between scheduled NATA audits. Maintaining concrete batching plant weighing accuracy Australia wide requires more than just software adjustments. It demands a robust physical installation that can withstand extreme heat, heavy vibration, and unstable power grids. If you don't account for these factors, your mix ratios will drift regardless of how often you reset the zero point.
Thermal Drift and Load Cell Sensitivity
Australian temperature extremes pose a significant challenge to load cell stability. In cities like Sydney or Melbourne, a 20-degree temperature swing in a single afternoon can significantly alter uncompensated readings by changing the electrical resistance within the load cell strain gauge. High-quality tank and silo weighing assemblies are designed with temperature-compensated sensors to mitigate this drift. Without these specialized components, your cement and aggregate scales may report false weights, leading to inconsistent mix ratios despite the control system showing "correct" values. It's a common cause of "ghost" material usage where the system thinks it's batching correctly while actually overfilling the hopper.
Mechanical Interference and Friction
Mechanical "binding" is a frequent yet overlooked issue in concrete plants. This occurs when the hopper frame or weighing vessel makes physical contact with surrounding structures, such as walkways or safety rails. Any contact point creates a secondary load path, diverting force away from the load cells. For concrete batching plant weighing accuracy Australia standards to be met, the weighing structure must maintain complete mechanical clearance to ensure gravity-only force reaches the sensors. You should regularly check for material build-up between the hopper and the frame; dried concrete or packed dust acts as a mechanical bridge that distorts gravimetric data and causes erratic batching results.
Electrical Surges and Signal Integrity
Regional Australian plants are particularly susceptible to electrical surges from lightning strikes or unstable grid switching. These spikes can blow out summing circuits or damage delicate weighing electronics. Installing junction boxes and surge arrestors is essential for protecting the signal path between the scale and the controller. Plant vibration from nearby mixers or conveyors also introduces "noise" into the weighing signal. High-precision indicators must use advanced digital filtering to distinguish between actual material weight and mechanical oscillation. This technology is critical for ensuring the batching process remains within the ±0.4% tolerance required by AS 1379, especially in high-volume plants where equipment is constantly in motion.

Establishing a NATA-Accredited Calibration and Maintenance Framework
A basic "check" performed by plant staff is not a substitute for a NATA-accredited calibration. While internal verification helps identify gross errors, only a NATA-endorsed report provides the legal and technical assurance required for AS 1379 compliance. NATA accreditation to ISO/IEC 17025 signifies that a laboratory has the specific competence, equipment, and traceability to perform measurements that hold up under legal and regulatory scrutiny. For concrete batching plant weighing accuracy Australia wide, this distinction is the difference between passing a Tier 1 contractor audit and being shut down for non-compliance.
Establishing a proactive maintenance framework in 2026 involves more than just waiting for the six-month mandatory interval. You need a structured approach that combines professional calibration with daily operational checks. To understand the full scope of these requirements, refer to our guide to AS 1379 compliance, which outlines the regulatory landscape for Australian producers.
The Calibration Process Step-by-Step
Professional calibration follows a methodical sequence to ensure every component in the weighing chain is performing correctly. Our technicians begin with a physical inspection of load cells, summing circuits, and junction boxes to identify signs of corrosion or mechanical binding. Once the hardware's integrity is confirmed, we perform gravimetric testing using certified weights traceable to national standards. This process includes:
- Zero-point stability testing: Ensuring the scale returns to zero consistently after loading.
- Linearity checks: Verifying accuracy across the entire weighing range, from minimum to maximum capacity.
- Repeatability tests: Confirming the scale provides the same reading for the same load multiple times.
- Eccentric loading: Ensuring weight is recorded accurately regardless of where it sits in the hopper.
Frequency and Risk-Based Assessments
AS 1379 mandates a calibration check at least every six months. However, high-volume plants or those operating in harsh environments, like coastal sites with high salt spray, often require quarterly inspections to manage risk. You shouldn't wait for the six-month mark if you notice signs of instability. If your scales show drifting zeros, erratic readings that "jump" during the batching cycle, or if your material reconciliation shows consistent discrepancies, you need immediate technical intervention. We provide AS 1379 compliant calibration services with the urgency required to minimise your downtime and protect your NATA-accredited status.
Documentation is the final, critical piece of the framework. Your NATA-endorsed reports must be kept on-site and easily accessible for auditors. These documents prove that your concrete batching plant weighing accuracy Australia standards are being met and that your equipment is traceable to international benchmarks. Without this paper trail, your structural concrete is technically uncertified, regardless of its actual strength.
Optimising Your Plant with High-Precision Industrial Weighing Solutions
Precision pays for itself. While meeting the minimum standards of AS 1379 ensures you stay operational, optimising your hardware for maximum concrete batching plant weighing accuracy Australia wide directly increases your return on investment. High-volume plants often suffer from cumulative material giveaway that goes unnoticed until the end-of-month reconciliation. By upgrading to high-precision weighing components, you reduce this "hidden" waste and ensure that every cubic metre of concrete produced matches the design mix exactly. This level of control is what separates market leaders from those struggling with inconsistent batch quality.
Downtime is the enemy of profitability in the concrete industry. A failed load cell or a malfunctioning indicator during a major pour can cost thousands in lost production and transport fees. This is why 24/7 emergency support is a critical component of any optimization strategy. Having access to a technician who understands the technical nuances of summing circuits and NATA requirements ensures your plant returns to service within hours, not days. Reliability in 2026 isn't just about the hardware; it's about the responsiveness of your service partner.
Upgrading Load Cells and Indicators
Standard load cells often struggle with the harsh mechanical environment of an aggregate hopper. Over time, vibration and environmental exposure lead to signal drift. Upgrading to high-precision, stainless steel load cells with superior IP ratings provides long-term stability and reduces the frequency of out-of-tolerance events. To effectively monitor these sensors, modern indicators and displays are essential. These units offer high-speed sampling rates that allow your controller to cut off material flow at the exact millisecond required, preventing the over-batching that erodes annual profits.
Local Australian stock is a non-negotiable requirement for modern plant managers. Waiting for international shipping during a hardware failure is not an option for serious producers. We maintain an extensive inventory of load cells and transmitters in Sydney, ensuring that replacement parts are available for immediate dispatch. This local presence is the backbone of our commitment to minimising client downtime across the country.
Comprehensive Service and Support
Independent Scale Service brings over 30 years of experience to the industry, currently servicing 98% of concrete plants across Sydney. Our technicians aren't just scale repairers; they're specialists in the specific demands of concrete production. We provide AS 1379 compliant calibration services that give you the NATA-endorsed documentation required to satisfy the most rigorous audits from Tier 1 contractors and government bodies.
Our methodical approach to concrete batching plant weighing accuracy Australia wide ensures that your facility remains a trusted supplier for major infrastructure projects. We focus on the technical details, from surge protection to gravimetric traceability, so you can focus on production. Contact Independent Scale Service for a NATA-accredited plant audit today to secure your compliance and optimise your batching precision for the year ahead.
Secure Your Plant’s Compliance and Profitability for 2026
Maintaining concrete batching plant weighing accuracy Australia wide is the primary safeguard against structural litigation and costly material waste. We've established that AS 1379 compliance requires ±0.4% static loading accuracy and that NATA-accredited calibration is the only path to legal traceability. By mitigating environmental factors like thermal drift and upgrading to high-precision load cells, you protect the structural integrity of every pour.
Independent Scale Service delivers the technical competence required to maintain these standards. With over 30 years of experience and a history of servicing 98% of concrete plants across Sydney, we're the trusted authority for industrial weighing. Our facility is NATA Accredited to ISO/IEC 17025, ensuring your documentation satisfies the most stringent Tier 1 contractor audits. Don't wait for a failed core test to address your scale drift.
Book an AS 1379 Compliant Calibration for Your Plant today to guarantee your operational excellence. We look forward to supporting your plant's continued success.
Frequently Asked Questions
How does weighing accuracy affect the mix of concrete ratio?
Weighing accuracy is the only way to maintain the specific water-to-cement ratio defined in the mix design blueprint. Inaccurate readings lead to the over-addition or under-addition of cement and water, which directly alters the compressive strength and workability of the concrete. This inconsistency often results in core test failures and expensive site remediation.
Is AS 1379 compliance mandatory for all Australian concrete plants?
Adherence to AS 1379-2007 (R2017) is mandatory for any producer supplying concrete for structural applications in Australia. This standard dictates that all weighing equipment must be checked for accuracy at least every six months. Failure to comply exposes the producer to significant legal and financial liability if a structural defect occurs on a project site.
What happens if a batching plant fails its NATA calibration?
If a plant fails to meet the ±0.4% static loading tolerance, it's technically non-compliant and cannot legally supply certified concrete. The weighing equipment must be adjusted or repaired by a qualified technician before a NATA-endorsed report can be issued. Continued operation without this certification puts your Tier 1 supply contracts and professional reputation at risk.
How often should a concrete batching plant be calibrated in 2026?
All weighing and liquid-dispensing equipment must be checked for accuracy at least every six months according to AS 1379. To ensure consistent concrete batching plant weighing accuracy Australia producers should consider more frequent intervals for high-volume sites. Quarterly calibrations are a common industry benchmark for plants producing over 50,000 cubic metres annually to prevent drift between audits.
Can environmental heat in Australia affect load cell accuracy?
Extreme Australian temperatures cause significant thermal drift in uncompensated load cells. Heat alters the electrical resistance within the sensor; this results in a false weight reading on the indicator even if no material is added. Professional installations use temperature-compensated load cells to ensure accuracy remains stable across 20-degree diurnal temperature shifts common in regional areas.
What is the difference between gravimetric and volumetric batching?
Gravimetric batching measures the physical mass of materials, while volumetric batching measures the space they occupy. Gravimetric is the superior method because it's unaffected by "bulking" in damp sand or changes in material density. This precision is why weight-based measurement is the required standard for high-strength structural concrete under Australian regulations.
What are the most common causes of weighing drift in a concrete plant?
The most frequent causes are mechanical binding of the hopper frame and material build-up between weighing components. Electrical interference from nearby motors and thermal drift from direct sunlight also contribute to drift. Regular cleaning and mechanical clearance checks are vital for maintaining signal integrity and preventing "ghost" weight readings that lead to material giveaway.
Does Independent Scale Service provide 24/7 emergency repairs for batching plants?
We provide a dedicated 24x7 emergency repair service specifically for industrial clients to minimise production downtime. Our technicians carry essential spares, including load cells and summing circuits, to resolve faults immediately. This service is a core part of our commitment to the 98% of Sydney plants we currently maintain and support.
